SCADA SYSTEM INTEGRATION

SCADA system integration unifies your PLCs, drives and field instruments into one real-time layer for monitoring, control, alarms and reporting. At ATMAN Group, we design and integrate SCADA systems in-house β€” as a single-window industrial automation partner since 2008, with AMUL-trained engineering leadership behind us.

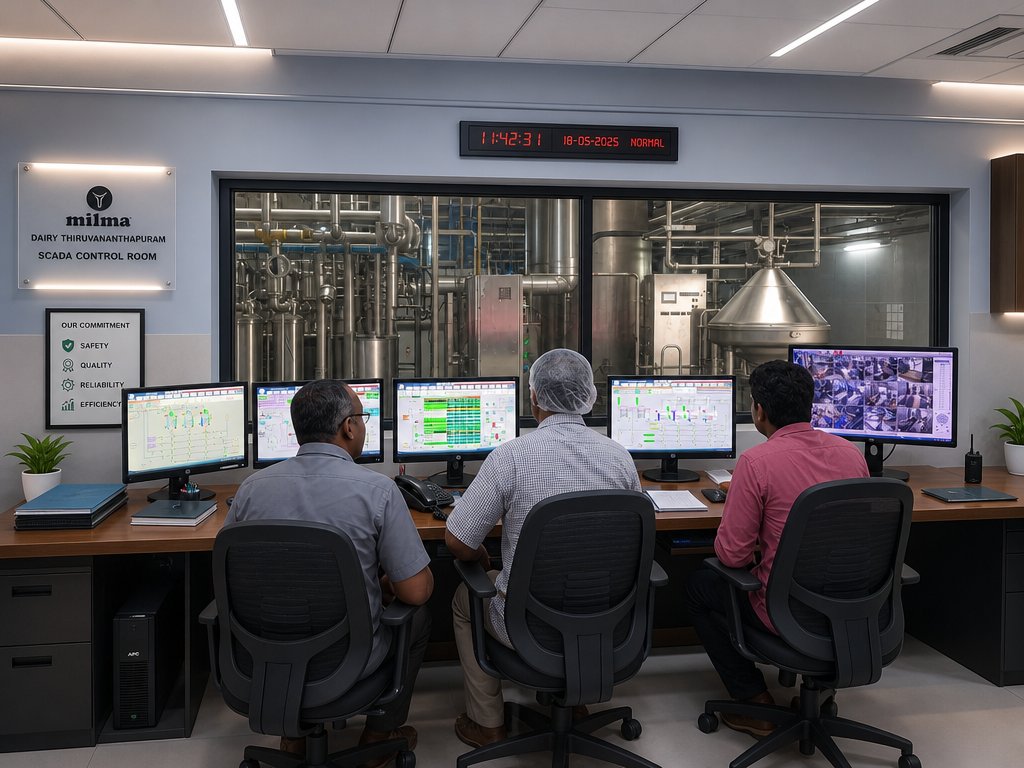

SCADA system integration and dairy plant control room β€” ATMAN Industrial Automation

What SCADA Integration Delivers

A unified control and visibility layer: real-time dashboards, alarm management, historical trends, batch and production reporting, and secure remote access β€” integrated with your PLCs, VFDs and instrumentation for one source of truth across the plant.

Our SCADA Integration Scope

  • SCADA/HMI architecture and screen development.
  • PLC, VFD and instrument integration and I/O mapping.
  • Alarms, trends, batch reports and production analytics.
  • Historian, data logging and remote monitoring.
  • Commissioning, operator training and support.

Applications

  • Dairy, food and beverage process monitoring.
  • Pharma and chemical batch control with traceability.
  • Water/ETP and utility SCADA.
  • Multi-line and multi-site plant dashboards.

Why ATMAN for SCADA Integration

  • In-house programming, panels and electrical under one roof.
  • Single-window accountability from architecture to commissioning and support.
  • Proven on turnkey dairy and process plants for cooperatives and NDDB-commissioned builds.
  • ISO 9001:2015 certified, documented and maintainable systems.

What β€œSCADA Integration” Actually Means

Buying SCADA software is procurement. Integration is the engineering that makes it work with the plant you already own β€” and that is where the cost, the risk and the value all sit.

A SCADA licence out of the box knows nothing about your plant. It does not know which tag is which vessel, what a normal temperature looks like, which alarm matters at 3 a.m. and which is noise, or how your operators actually run a changeover. All of that is integration work, and none of it comes in the box.

A useful way to separate bidders: ask what happens in week three of the project. A supplier selling software will talk about licences and screens. An integrator will talk about reading your P&IDs, listing your tags and sitting with your shift operators.

Talking to What Is Already Installed

Almost no plant is single-vendor. A working dairy or process plant accumulates equipment over twenty years, and integration means getting all of it onto one screen without replacing any of it.

What is already thereHow we reach itWhere the difficulty usually is
Siemens S7-1500 / S7-300 / S7-400PROFINET or PROFIBUS, directStraightforward β€” this is home ground
Third-party PLCsModbus TCP or OPC UA where the vendor exposes itTag documentation is often missing and has to be rebuilt by inspection
OEM machine controllers (fillers, packing lines, CIP skids)Whatever the OEM exposes β€” often a restricted subsetThe OEM may not want to share the tag list. Getting it is a commercial negotiation as much as a technical one
Drives and soft startersPROFINET, Modbus, or hardwired signalsDeciding what is worth reading β€” a drive can expose hundreds of parameters and you need about eight
Energy metersModbus RTU or TCPPhysical wiring runs and meter addressing, rarely the protocol
Inline analysers, weighbridges, flow computersSerial, Modbus, or vendor protocolScaling, units and update rates β€” a wrong scaling factor is worse than no reading
Truly legacy controllers with no data pathGateway, or read the field signals independentlySometimes the honest answer is a controller migration

OPC UA is the usual bridge where mixed hardware has to coexist, and it is the right default for anything new. It is not universal β€” plenty of installed equipment predates it, and pretending otherwise leads to a nasty surprise at commissioning. We establish what each device can actually deliver during survey, in writing, before the architecture is fixed.

Architecture β€” Sized Honestly

Over-specified SCADA is a common and expensive mistake. So is under-specified. The decision follows from what the plant loses when the SCADA station is unavailable β€” not from what the brochure recommends.

ArchitectureSuitsWhat it costs you
Single stationOne process area, one control room, plant survives on local HMI if SCADA is downLowest cost. No visibility during maintenance or a PC failure
Server with clientsMultiple control rooms, QC, maintenance and management needing viewsServer sizing, licences per client, a real network
Redundant server pairContinuous operation where losing supervision stops or endangers productionRoughly double the server cost β€” justified far less often than it is sold
Distributed / multi-siteSeveral plants or remote assets under one viewTelemetry design and store-and-forward become the hard part β€” see remote monitoring

On Siemens we work with WinCC and WinCC Unified. Which one depends on the installed base, the client mix and whether browser-based access matters to you. We will state the reason for the recommendation rather than defaulting to the newest option.

The redundancy question deserves a blunt test: if the SCADA server failed right now, would the plant stop? On many plants it would not β€” the PLCs keep running and the local HMIs keep operating. If that is your situation, redundancy is buying comfort, not availability, and the money is better spent on alarm quality or historian depth.

The Alarm System Is Where Most SCADA Projects Fail

This is the single biggest difference between a SCADA that gets used and one that gets ignored, and it is almost never in the specification.

The default approach is to alarm everything, because it feels safe and it is easy. The result is an alarm list scrolling faster than anyone can read, on which every alarm is high priority. Operators do the only rational thing available to them: they stop looking. When the alarm that mattered finally arrives, it scrolls past with the other four hundred.

  • Rationalise before configuring. Every alarm must have an operator action attached to it. If there is nothing for anyone to do, it is an event to be logged, not an alarm
  • Priority discipline. If everything is critical, nothing is. Priorities are allocated deliberately, in a workshop, with your operators β€” not assigned by default
  • Deadbands and delays on analogue alarms, so a signal hovering at setpoint does not generate a hundred entries an hour
  • Suppression during known states β€” a vessel alarming empty during CIP is noise, and it teaches operators to ignore the list
  • First-out and grouping, so a trip presents as one cause rather than forty consequences
  • Shelving with a timer and a reason, so a nuisance alarm can be parked without being silently forgotten
  • Measure it after commissioning. Alarms per operator per hour is a number with a target. If it is in the hundreds, the system has failed regardless of how good the screens look
Ask any SCADA bidder how they will rationalise your alarms and what alarm rate they will hand over against. Most have never been asked, and the answer tells you whether they have run a plant or only built screens.

Tag Standards and the Data Model

Unglamorous, done at the start, and it determines whether the system is maintainable in year five.

  • A naming convention decided before the first tag is created β€” area, equipment, function, signal type. Retrofitting a convention onto 4,000 existing tags is a project nobody funds
  • Engineering units and scaling documented, not carried in an engineer’s head
  • Structured types so a valve is configured once and reused, rather than copied 200 times with 200 chances to differ
  • Alignment with the PLC symbol table, so a tag traced from screen to controller to terminal is the same name throughout
  • An exported, maintained tag list as a handover deliverable

The test of a data model is simple: a new engineer, on day one, with no help β€” can they find the tag for a specific field device? If not, every future change costs more than it should.

Historian, Reporting and the Route to MIS

Live screens answer what is happening now. Most of the commercial value is in what happened last month.

  • Retention sized on purpose β€” high-resolution recent data, compressed history further back. Storing everything at one-second resolution forever is a cost with no return
  • Batch and shift reports generated automatically, with deviations against recipe or limit flagged
  • Audit-ready records β€” for a dairy, the CIP and pasteurisation history an inspector will ask for, retrievable in minutes rather than reconstructed
  • Export to MIS or ERP on a defined interface, so production and consumption figures stop being retyped
  • Energy against output, which is where the recoverable cost usually hides

Where the requirement is analysis and management reporting rather than plant supervision, a separate layer is often the better answer than pushing SCADA into a job it was not designed for β€” see plant dashboards and monitoring.

Screens Operators Actually Use

Screen design is treated as decoration and is actually ergonomics. A screen is read under pressure, at speed, by someone who has been on shift for nine hours.

  • A hierarchy, not a pile β€” plant overview, then area, then equipment detail. Any relevant screen within two clicks
  • Colour carries state, nothing else. If colour is used for decoration, it stops signalling. A calm screen where colour means something beats a colourful one
  • Abnormal is visible from across the room β€” the point of an overview is that a passing supervisor sees trouble without studying it
  • Trends beside values, because a number without direction is half the information
  • Consistent placement and interaction across every screen β€” muscle memory is a safety feature
  • Designed with the operators who will use it, and revised after they have run it for a fortnight

Security

A SCADA network is a control network. It deserves a straight answer rather than reassurance.

  • Separation between control and business networks, not a flat network with SCADA attached to it
  • Role-based access β€” operator, supervisor, engineer β€” with setpoint limits enforced by role, not by convention
  • An audit trail on every setpoint and recipe change: who, what, when, previous value. This settles arguments as often as it satisfies auditors
  • Remote access enabled when needed, not left permanently open, with sessions logged
  • Backups of the SCADA project itself, restore-tested β€” the same discipline as PLC backups. See automation support

How an Integration Project Is Planned

  1. Survey. Every controller, protocol, network path and existing tag list. What each device can genuinely deliver, written down
  2. Functional design specification. Screens, alarms, users, reports, interfaces β€” signed off before configuration starts. This document is what makes acceptance objective instead of a matter of opinion
  3. Alarm rationalisation workshop with operations and maintenance in the room
  4. Tag standard and data model agreed and documented
  5. Configuration and internal test against simulated I/O
  6. Factory Acceptance Test β€” you witness it before it comes near the plant
  7. Site installation and Site Acceptance Test, phased by area where the process allows, with the existing system available until the new one is accepted
  8. Operator training on the real system, not a slide deck
  9. Handover β€” as-built screens, tag list, alarm register, backups, documentation
  10. Post-commissioning review after a few weeks of live running, when the real alarm behaviour and the screens people avoid have both become obvious
Step 10 is the one usually skipped and the cheapest to include. Nobody knows how a SCADA really behaves until it has run a full production cycle, and the fixes identified then are small if they are made promptly.

Where SCADA Ends and Other Systems Begin

These four get conflated in specifications and budgets, which is how projects end up with the wrong tool doing the wrong job:

LayerJobWho uses it
PLCControls the process in real time. Runs whether anything above it existsNobody directly β€” it just runs
HMILocal operation at the machine or panel. Works when the network does notOperator at the equipment
SCADAPlant-wide supervision, alarms, trends, recipes, operating historyControl room, shift in charge
MIS / dashboardsAnalysis, KPIs, cost and management reportingPlant head, management, board

A frequent and expensive error is asking SCADA to be the management reporting system. It can export the data; it is not the place to analyse it. Keep the layers distinct and each one does its job properly.

For dairy-specific supervision β€” CIP circuits, pasteuriser and FDV proving, reception, batch genealogy β€” see dairy plant automation.
